The Strategic Role of Mechanical Completion in the Construction of Floaters
Andrea Pigozzo Andrea Pigozzo

The Strategic Role of Mechanical Completion in the Construction of Floaters

In large FPSO and FLNG projects, Mechanical Completion is often measured by volume—how many subsystems are closed, how fast the skyline grows. But progress is not about volume, it is about value.

A subsystem completed out of sequence, or not truly ready, has little impact on the project. It may appear “100% complete” on paper, yet still cannot be turned on due to missing utilities, incomplete loops, or critical punch items. This is where many projects lose time: commissioning receives systems that cannot advance the sequence.

The reality is that perfect Mechanical Completion across a complex plant is almost never achievable on schedule. Late engineering, procurement delays, and the sheer number of workfronts make it unavoidable. The key is not to wait for perfection, but to enable progress.

Successful projects focus on delivering subsystems in the right order, ensuring they are actually usable by commissioning, and applying a risk-based approach to handover. Mechanical Completion is not a finish line—it is a transition.

Value is created when the right systems are completed, in the right sequence, at the right level of readiness to move forward.

Read More
The West’s Vanishing Shipyards: Strategic Risks in the Globalization of FPSO and FLNG Fabrication
Andrea Pigozzo Andrea Pigozzo

The West’s Vanishing Shipyards: Strategic Risks in the Globalization of FPSO and FLNG Fabrication

🌍 The West no longer builds its own offshore energy infrastructure.

FPSO and FLNG fabrication has almost entirely shifted to Asia.

What started as a cost decision has become a strategic dependency.

⚠️ What’s at risk?

• Loss of execution know-how
• Dependency on foreign yards for critical assets
• Exposure to geopolitical risk (e.g. sanctions)

The uncomfortable truth: we still choose yards based on cost and schedule—but don’t price long-term risk.

FPSOs and FLNGs are not just projects, they are energy security infrastructure.

And today, most of it is no longer built in the West.

👉 Are we underestimating this shift?

Read More
Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 3rd part: The Power of Cranes
Andrea Pigozzo Andrea Pigozzo

Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 3rd part: The Power of Cranes

🏗️ The Power of the Crane: Why Lifting Capacity Shapes Offshore Construction

In offshore megaprojects like FPSOs and FLNGs, cranes are more than just tools—they’re strategic assets.

From gantry cranes towering over dry docks to floating barge cranes capable of lifting thousands of tons, the ability to move massive modules in a single lift can define a shipyard’s efficiency, safety, and competitiveness.

But not all shipyards are created equal.

Some rely on modular assembly, others on one-lift integration. Some have deepwater quays for in-yard commissioning, others depend on remote bases.

As offshore units grow larger and heavier, crane capacity becomes a key differentiator in global yard capability.

🔍 Curious how China and South Korea compare?

Read More
Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 2nd part: infrastructures
Andrea Pigozzo Andrea Pigozzo

Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 2nd part: infrastructures

🔍 Infrastructure Matters: Why Shipyard Scale Still Defines Offshore Capability
In the world of offshore energy, delivering complex units like FPSOs and FLNGs isn’t just about engineering excellence—it’s about infrastructure readiness.
In this analysis, we explore how shipyard area alone can shape a yard’s ability to execute large-scale offshore projects. South Korean shipyards like HD Hyundai Heavy Industries, Samsung Heavy Industries, and Hanwha Ocean lead the way with massive footprints and high utilization, while many Chinese yards Yantai CIMC Raffles Offshore Ltd., Wison New Energies COSCO (Qidong) Offshore Co., Ltd are emerging in integration and throughput.
📏 Did you know?
FLNGs can exceed 400 meters in length and 200,000 tons in dry weight.
Some shipyards operate at over 6 million m², enabling full topside integration and float-over operations.
Environmental resilience is critical—BP’s Tortue FPSO drifted during Typhoon Muifa in 2022, reminding us that even modern yards must plan for extreme weather.
🛠️ This article focuses on yard area as a key metric. In upcoming posts, we will dive into crane capacity and quay design—two more pillars of offshore readiness.

Read More

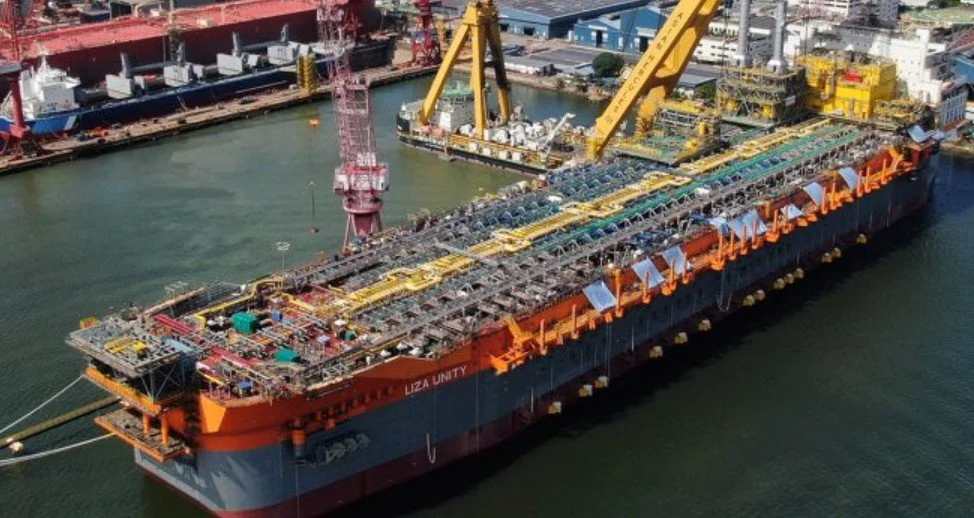

De-Risking the Critical Path in FPSO and FLNG Execution Schedules: part 3 - offshore campaign
Andrea Pigozzo Andrea Pigozzo

De-Risking the Critical Path in FPSO and FLNG Execution Schedules: part 3 - offshore campaign

Why the Best Offshore Campaigns Are the Most Boring

Offshore campaigns are the final—and most unforgiving—phase of FPSO and FLNG projects. Every decision offshore costs 3× more time, 3× more money, and 3× more coordination than in the yard.

The secret? Plan the boring. Deliver the brilliant.

In this article for Floaters Intelligentia, we break down:
✅ Why offshore campaigns fail without early risk retirement
✅ The five-step critical path (from mooring to start-up)
✅ SIMOPS, POB constraints, and contractor strategy
✅ How to turn chaos into choreography

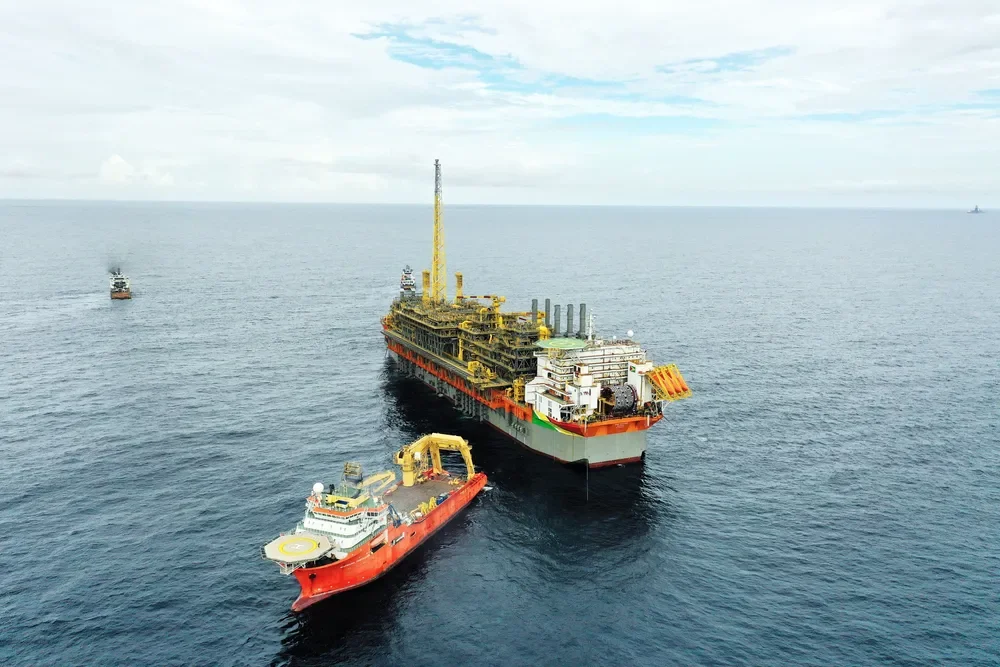

If you’ve ever stood at a muster station during a gas alarm, you know why clarity matters.

Image source: SBM

Read More
De-Risking the Critical Path in FPSO and FLNG Execution Schedules: part 2 - Topside
Andrea Pigozzo Andrea Pigozzo

De-Risking the Critical Path in FPSO and FLNG Execution Schedules: part 2 - Topside

In FPSO/FLNG projects, the critical path isn’t fixed—it shifts.

🔧 Turbomachinery still dominates early planning.
⚙️ But during integration, ICSS becomes the real bottleneck: >1,000 km of cables, terminations, loop checks—delays here stop everything.

🔩 Headers and closure welds play a key role in keeping the schedule intact, especially when late changes hit.

📊 The takeaway?
It’s no longer about a single critical activity—it's about managing interfaces across systems.

✅ Prioritize early energization
✅ Align fabrication and integration
✅ Use engineering decisions as schedule tools

Because today, project success depends on how well you manage complexity—not just the plan.

Image Source: SBM

Read More
De-Risking the Critical Path in FPSO and FLNG Execution Schedule: part 1 - Hull
Andrea Pigozzo Andrea Pigozzo

De-Risking the Critical Path in FPSO and FLNG Execution Schedule: part 1 - Hull

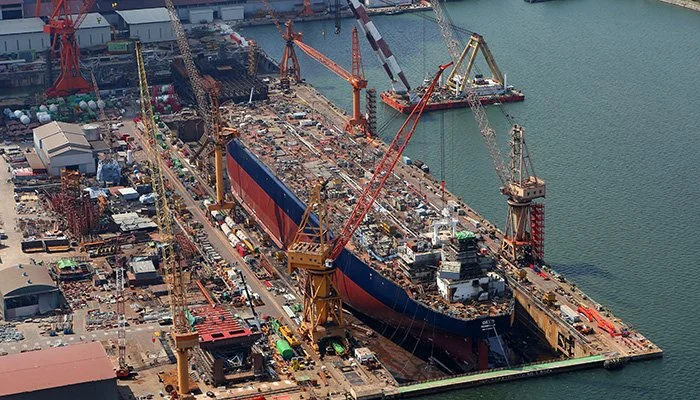

🚢 Schedule Optimization in FPSO & FLNG Projects – Part 1: Hull Construction & Refurbishment 🛠️

Hull schedules are not driven by steel alone. Dry dock strategy, Class hold points, and cargo containment choices often decide whether dock‑out is achieved on time—or not.

From recent projects:

• Block size and lifting strategy (grand / giga blocks) heavily influence dry dock duration
Class‑imposed dock‑out requirements are hard constraints, not close‑out items
• For FLNGs, containment matters:
– GTT membranes offer post–dock‑out flexibility
– SPB systems impose pre–dock‑out structural and testing constraints

Schedule robustness is built early, at the intersection of yard capability, Class rules, and technology selection.

(Image source: Modec)

Read More
Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 1st part: track record
Andrea Pigozzo Andrea Pigozzo

Asia’s Offshore Giants: Comparing Chinese and South Korean Shipyards in FPSO and FLNG Construction. 1st part: track record

We’ve just refreshed our analysis on the competitive landscape of offshore floating units (update April 2026). The update includes:🔹 Latest project status (FPSO, FLNG, FPU, FSO) 🔹 Builder rankings and multi-yard strategies 🔹 Key observations on market trends and technology leadershipHighlights:Samsung Heavy Industries (South Korea): 4 FLNG delivered, 3 ongoing, plus major FPSO/FPU projects. COSCO (China): Emerging as the biggest multi-yard player with 6 units delivered and 5 ongoing. Wison Offshore & Marine (China): Leading Chinese FLNG builder with 2 delivered and 1 ongoing.South Korea continues to set the benchmark in FLNG integration and heavy-lift capability, while China is diversifying aggressively with FPSO, FLNG, FPU, and FSO projects—reshaping the global offshore construction market.

Read More
Offshore Giants Under Threat? Why FPSOs and FLNGs Remain Among the Hardest Energy Assets to Attack
Andrea Pigozzo Andrea Pigozzo

Offshore Giants Under Threat? Why FPSOs and FLNGs Remain Among the Hardest Energy Assets to Attack

Recent geopolitical events have shown how vulnerable large onshore energy facilities are to modern threats like drones and long‑range missiles. By contrast, FPSOs and FLNGs offer a completely different security profile.

Here’s why offshore is winning in resilience:

🌊 Distance = Safety

🏰 Floating Fortresses

🛡 Structured Protection

‍ ‍👥 Crew Safety by Design

💻 Cyber + Physical Security

As energy infrastructure becomes increasingly targeted, offshore production stands out as one of the safest and most resilient ways to operate.

Read More
FLNG and Onshore LNG in Mozambique: Why a 50–50 Hybrid Strategy Would Have Been the Prudent Choice from Day One
Market Andrea Pigozzo Market Andrea Pigozzo

FLNG and Onshore LNG in Mozambique: Why a 50–50 Hybrid Strategy Would Have Been the Prudent Choice from Day One

Why Mozambique Should Have Followed the Guyana Playbook: FLNG First, Onshore Later

In the last decade, ExxonMobil’s strategy offshore Guyana has become a benchmark for rapid, de‑risked development: one FPSO per year, scaling from Liza Destiny (2019) to Liza Unity (2022), Prosperity (2023), and ONE GUYANA (2025).
This modular, disciplined approach pushed Guyana beyond 900,000 barrels/day in under five years.

But while this floating‑first strategy turned Guyana into a global deepwater success story, Mozambique took a different path — tying its massive Area 1 and area 4 gas discoveries to an onshore LNG complex in Afungi: remote, infrastructure‑poor, and ultimately disrupted by instability.

What if Mozambique had matched Guyana’s disciplined offshore model?

#FLNG #FPSO #LNG #Mozambique #Guyana #EnergyTransition #OffshoreEnergy
#FloatingSolutions #OilAndGas #Deepwater #Engineering #ProjectExecution
#EnergySecurity #MaritimeEngineering #FloatersIntelligentia

Read More
Why Collecting Lessons Learned Is the Lifeline of Offshore Projects
Andrea Pigozzo Andrea Pigozzo

Why Collecting Lessons Learned Is the Lifeline of Offshore Projects

Collecting Lessons Learned: The Shortcut to Excellence
Offshore projects are long, complex, and dynamic. Teams change, priorities shift, and knowledge often gets lost along the way.

Collecting lessons learned is the best shortcut to excellence. Don’t let knowledge disappear—capture it, share it, and use it to build the next success story.

#ProjectManagement #LessonsLearned #ContinuousImprovement #OffshoreProjects #EnergyIndustry #Leadership #OperationalExcellence #RootCauseAnalysis #InnovationInExecution #FloatersIntelligentia

Read More
Construction All Risks Insurance in Offshore Projects: Policy Architecture, Thresholds, Limits & Marine Warranty Surveyor Involvement
Regulations Andrea Pigozzo Regulations Andrea Pigozzo

Construction All Risks Insurance in Offshore Projects: Policy Architecture, Thresholds, Limits & Marine Warranty Surveyor Involvement

🔍 Offshore projects carry massive risk—from heavy lifts to long-haul tows. Construction All Risks (CAR) insurance isn’t just financial protection; it’s a governance tool.
✅ Why it matters:
Covers fabrication, load-out, transit, installation, and commissioning
Embeds Marine Warranty Surveyor (MWS) approvals as a condition precedent
Makes Management of Change (MoC) critical—unapproved changes can void coverage
💡 Learn how CAR programs align technical readiness with insurance compliance, and why threshold rules and COA gates are essential for FPSO and FLNG success.
👉 Read the full article below

Read More
Classification and Flagging for FPSO and FLNG — a practical primer
Andrea Pigozzo Andrea Pigozzo

Classification and Flagging for FPSO and FLNG — a practical primer

Today we published a new article summarizing the essential role of classification and flagging in FPSO and FLNG projects.
Too often, class is seen as a formality — a checkbox.
In reality, it is the technical, regulatory, and commercial backbone of every floating production system.
🔹 Independent technical assurance that reduces project and operational risk
🔹 Statutory compliance through MARPOL, SOLAS, MODU Code and more
🔹 Lifecycle discipline via inspections, IIP programs and modification rules
🔹 Financing & insurance requirements demanded by banks and underwriters
🔹 Specialized notations that are essential for FLNG cryogenic systems
🔹 Global portability & access to yards, terminals, and future redeployment
🔹 Commercial clarity in chartering, offtake, and handover documentation
At Floaters Intelligentia we continue to highlight how the right assurance model — class, flag, and regulator — is a strategic decision that shapes the whole project lifecycle.
If you work in FPSO/FLNG project management, engineering, classification, assurance or operations, this framework is essential.
More insights coming soon.

#FPSO #FLNG #OffshoreEnergy #MaritimeRegulations #Classification #MARPOL #SOLAS #FloatersIntelligentia #OffshoreProjects #EnergyIndustry

Read More
Planner: The Brain of the Team — and How to Create Useful KPIs
Andrea Pigozzo Andrea Pigozzo

Planner: The Brain of the Team — and How to Create Useful KPIs

In FPSO and FLNG execution, the planner isn’t just a scheduler—they’re the strategic nerve center.
They connect engineering, procurement, fabrication, and commissioning, while acting as the alarm bell for critical and near-critical paths.
✅ In our latest article, we explore:
Why planners are the “brain” of the team
How to design KPIs that give real visibility without drowning supervisors in details
Practical rules for update cadence and stagnation alerts
Read the full article and discover how smart KPIs turn complexity into control.

‍ ‍

#ProjectControls#FPSO#FLNG#PlanningExcellence#ConstructionManagement#ProjectManagement#KPI#OffshoreProjects#ProjectExecutionhashtag#EnergyIndustry#FloatersIntelligentia#LeadershipTools#CriticalPath

Read More
Leased vs. Owned FLNG/FPSO Units: Financial Implications and Strategic Trade-offs
Andrea Pigozzo Andrea Pigozzo

Leased vs. Owned FLNG/FPSO Units: Financial Implications and Strategic Trade-offs

Should oil companies lease or own FPSO/FLNG units?
This decision impacts CAPEX vs OPEX, risk allocation, and long-term flexibility—and it’s far from simple.

Leased Units: Lower upfront CAPEX, faster deployment, and redeployment flexibility.
Owned Units: Higher control, potential long-term savings, but greater risk exposure.
Hybrid Models: Lease-to-own strategies combine agility with asset control.

In our latest article, we explore:

  • Financial structures under IFRS 16 & ASC 842

  • Risk allocation and operational responsibility

  • Real-world examples like SBM Offshore’s Alexandre de Gusmão FPSO for Petrobras

  • Strategic trade-offs for marginal vs. long-life fields

#FPSO #FLNG #OffshoreEnergy #OilAndGas #AssetManagement #CAPEXvsOPEX #EnergyStrategy #Petrobras #SBMOffshore #FloatersIntelligentia

Read More
🛠️ The Power of Teams in Floaters Projects
Andrea Pigozzo Andrea Pigozzo

🛠️ The Power of Teams in Floaters Projects

FPSO/FLNG success isn’t just about steel and systems—it’s about people.Every floater project is unique. That’s why the teams behind them must be engineered with the same precision as the structure itself.

✔ Build teams as unique as your project

✔ Balance global expertise with local fluency

✔ Use soft skills as performance accelerators

✔ Capture lessons so value doesn’t disappear at project close

Steel doesn’t float without people. Engineer the team—and the project follows.💡 How do you build trust fast in a newly formed offshore team? Read the full article at link below and share your thoughts.

#FloatersIntelligentia #FPSO #FLNG #TeamEngineering #ProjectLeadership #OffshoreDevelopment #HumanFactor #SoftSkills #EnergyProjects #GlobalTeams

Read More
The Contingency Plan for an Offshore FLNG Construction Hook-Up Manager
Andrea Pigozzo Andrea Pigozzo

The Contingency Plan for an Offshore FLNG Construction Hook-Up Manager

🚢 The Importance of Contingency Planning for Offshore Hook-Up Campaigns 🌊
In offshore projects, hook-up campaigns are among the most critical phases—where multiple disciplines converge, timelines are tight, and risks are amplified.
But what happens when the unexpected strikes?
⚠️ Weather delays
⚠️ Equipment failures
⚠️ Logistics bottlenecks
Without a solid contingency plan, these issues can escalate into costly delays and safety hazards.
In this latest article, we will explore:
✅ Why contingency planning is non-negotiable for offshore hook-up campaigns
✅ Key elements of an effective plan
✅ Lessons learned from real-world projects

#Offshore #HookUp #ContingencyPlanning #OilAndGas #ProjectManagement #HSE #RiskManagement

Read More
